Under constructionApartment

Dubai Industrial City · Dubai

Al Haseen Residences Phase 5

by City Properties

© City Properties
41of 100
Fromper propertyfinder.ae, 1 Oct 2026
AED 594K≈ $162K
Price, payment plan and homes ↓
The full breakdownSee the 4 registered sales at Al Haseen Residences Phase 5: date, size and price paid. Plus all 8 factor scores and the score history. Free.Unlock free →

Price, payment plan and homes

Price per propertyfinder.ae, 1 Oct 2026
Starting price
AED 594K
≈ $162K
Bedrooms
Studio to 3 bed
368 – 1,818 sqft · 245 units
Payment plan
20/20/60
AED 119K to book
Handover
Q2 2027
4% built per the DLD · likely later

Homes and floor plans

245 homes · Freehold

Pick a home: the plan and the forecast follow it.

  • Al Haseen Residences Phase 5 Studio apartment floor plan
  • Al Haseen Residences Phase 5 1 bed apartment floor plan
  • Al Haseen Residences Phase 5 2 bed apartment floor plan
  • Al Haseen Residences Phase 5 3 bed apartment floor plan

Payment plan · studio

On AED 594K
  1. 20% at bookingAED 119K
  2. 20% during construction, until handover (Q2 2027)AED 119K
  3. 60% on handover (Q2 2027)AED 356K

Before the keys: AED 238K, 40% of the price.

Open in the map

Location · Dubai Industrial City · Dubai

Industrial and logistics city in the south of Dubai, off Emirates Road, with a growing residential quarter.

Forecast

What the studio could be worth

The in-depth review

Why it scores 41

Price per sqft vs registered sales

Dubai Land Department open data

AED 1,607/sqft (est.)

The DLD median for apartments in Dubai Industrial City is AED 1,391/sqft (as of 10 Nov 2026). This project's figure is our estimate from the listed prices and unit sizes, so no gap is shown here; the score's price factor reads it at half weight, capped at 70. The gap appears once the register shows ten of this project's own sales or the developer states a price per sqft.

How the 41 was scored

8 of 8 factors · 100% of the weight · 10 Nov 2026
Confidence: low
How each factor was measured

Each factor with what it was measured on. Its score and the reasoning are in the full breakdown.

Price against what buyers actually paid
Our estimate from its typical home, against the median of 340 off-plan sales in Dubai Industrial City · DLD
Developer track record
Our rating and 1 delivered projects
Payment plan
20% down · 20% during construction · 60% on handover
Location and infrastructure
Our rating of Dubai Industrial City, and 5 kinds of places measured from the pin · OpenStreetMap
How big the resale market is
19 resales of finished apartments in Dubai Industrial City this year · DLD
Construction on schedule
4% built on the DLD register, handover Q2 2027
How much is still being built nearby
652 homes sold in Dubai Industrial City this year, 95% off-plan · DLD
The basics on file
Registration or escrow number on file · DLD

Confidence low: the price figure is our estimate from the price and size of the typical home, not a registered or stated price.

42 → 41 4 Oct 2026; resale now measuredScored since 24 Sep 2026 · 6 score changes

The formula is public: how the Rendr Score works. Our opinion, not investment advice. A figure you believe is wrong: alexk.dxb02@gmail.com.

Share this score
Show this score on your site

Paste this where the badge should appear. It links back here and updates when the Rendr Score does.

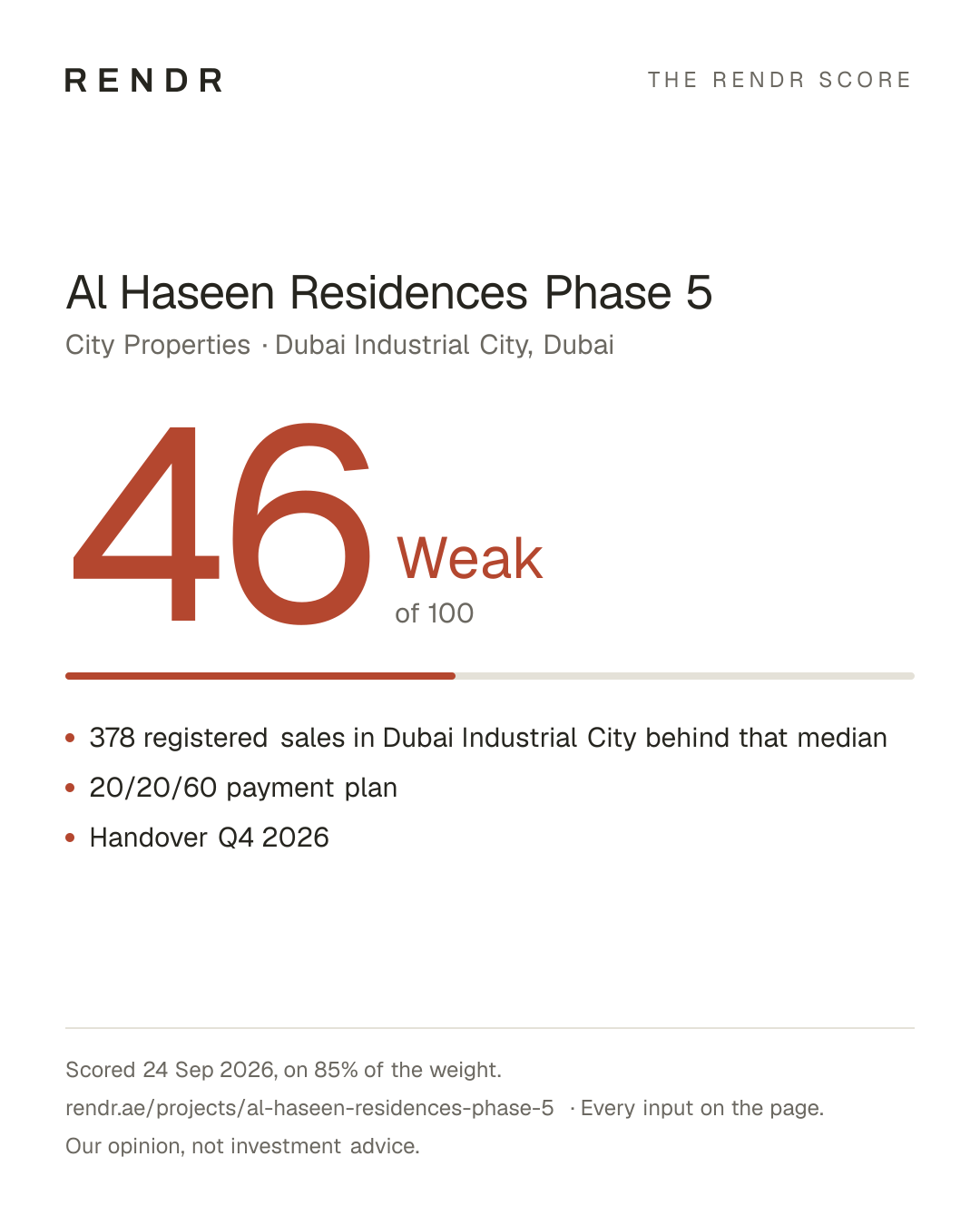

Score card · Change card (1080 × 1350, for posting).

Free · 90 days · the whole site

The full breakdown behind the 41

Free for 90 days. One sign-up opens everything on the site: the breakdown behind all 1,673 scored projects, the figures and reasons behind the developers' ranking, and rent, a mortgage and fees in every forecast. Nothing to pay.

  • The 4 registered sales here: date, size and price paid
  • All 8 factor scores, with the figure and source behind each
  • Score history since 24 Sep 2026 and why each move happened
  • Rent, a mortgage and fees in the forecast, year by year

See what buyers paid at Al Haseen Residences Phase 5, and everything behind the 41.

All fields are required.

+971

Read by the person who runs Rendr, who works in real estate and may contact you about property. Never sold.

I am
Projects scored
1,673
projects scored
Factors
8
factors, formula public
Registers
ADREC · DLD
registered sales, not asking prices

Handover date

Q2 2027

Under construction · 4.22% built, the DLD's project register, 28 Sep 2026

What this means

Listed as Q4 2026 on 24 Sep 2026. The DLD’s register now expects Q2 2027 (28 Sep 2026).

Also due in 2027 in Dubai Industrial City: 6 more projects we list

City Properties: 1 project delivered in the last ten years, typically 12 months late, none cancelled.

Al Haseen Residences Phase 5 is due to hand over in Q2 2027. Construction is 4.22% complete according to the DLD's project register (28 Sep 2026). At that progress it cannot hand over by Q2 2027 at any usual building pace. Handover dates are the developer's own estimate and off-plan schedules move, so confirm the current date in writing before paying anything.

DLD registration status

Verified 1 Oct 2026
  • Project registration4461
  • Escrow account11879528920008
  • Developer licenceNot published yet
Where the figures come from

Check it on dubailand.gov.ae. How to read the DLD register.

Figures from propertyfinder.ae, read 1 Oct 2026, last verified 1 Oct 2026. Construction figure from the DLD's project register, 28 Sep 2026. Launch date from the DLD's project register.

Before you pay: four things to check

  1. 1The escrow accountPay only into escrow account 11879528920008, and check it on dubailand.gov.ae first.
  2. 2The handover dateThe listed date is Q2 2027. The DLD shows 4% built on 28 Sep 2026, a pace that points to later. Ask for the date in the sales agreement.
  3. 3Today's price listAED 594,000 is a starting price from propertyfinder.ae, 1 Oct 2026. Ask for the unit's own price.
  4. 4The instalment dates20% at booking, 20% during construction, 60% at handover. Ask for each payment's date and amount.

About

Al Haseen Residences Phase 5 is City's apartment tower in Dubai Industrial City, Dubai, with studios to three-bedroom apartments from about 368 to 1,818 sq ft.

Developer
City Properties
Area
Dubai Industrial City
Status
Under construction
Sales launch
3 Dec 2025
Total units
245
Storeys
8
Ownership
Freehold

Amenities

  • Indoor Swimming Pool
  • Landscaped Gardens
  • CCTV Security
  • Gymnasium
  • Restaurants
  • Children's Play Area

What’s nearby

straight-line distance
  • Supermarket or mall4.4 km
  • Hospital or clinic7.9 km
  • Metro or tram stop12 km
  • Beach12 km
  • School17 km

The nearest of each on OpenStreetMap, Sep 2026.

Al Haseen Residences Phase 5: questions buyers ask

How much does Al Haseen Residences Phase 5 cost?

Prices at Al Haseen Residences Phase 5 start from AED 594,000 (about $162K) and reach AED 2,910,000 for studios, 1-bedroom, 2-bedroom and 3-bedroom homes, per propertyfinder.ae on 1 Oct 2026.

What is the price per sqft at Al Haseen Residences Phase 5?

The asking price is around AED 1,607 per sqft, our estimate from the listed prices and unit sizes.

When is the Al Haseen Residences Phase 5 handover date?

Al Haseen Residences Phase 5 is expected to hand over in Q2 2027. The project is under construction, 4.22% built according to the DLD's project register.

What is the Al Haseen Residences Phase 5 payment plan?

Al Haseen Residences Phase 5 is offered on a 20/20/60 plan: 20% on booking, 20% during construction and 60% at handover.

What is the Rendr Score of Al Haseen Residences Phase 5?

Al Haseen Residences Phase 5 scores 41 of 100 on the Rendr Score, weak, as of 10 Nov 2026; 8 of its 8 factors are assessed, 100% of the weight.

Who is the developer of Al Haseen Residences Phase 5?

Al Haseen Residences Phase 5 is being developed by City Properties. It sits in Dubai Industrial City, Dubai.

Is Al Haseen Residences Phase 5 registered with DLD?

Al Haseen Residences Phase 5 is registered with the Dubai Land Department (DLD) under number 4461. Buyer payments go to escrow account 11879528920008. Check it at dubailand.gov.ae before you pay.

Changes

Listed 24 Sep 2026 · 4 changes since, last 28 Sep 2026
  1. Handover moved from Q4 2026 to Q2 2027

    Source: the DLD's project register, 28 Sep 2026

  2. Construction 4.22% complete

    Source: the DLD's project register, 28 Sep 2026

  3. Sales launch date set to 3 Dec 2025

    Source: the DLD's project register

  4. Payment plan stated: 20/20/60

    Source: propertyfinder.ae, read 24 Sep 2026

  5. Listed on the site

    Source: propertyfinder.ae, read 24 Sep 2026

From

AED 594K

Similar projects ↓
